Eurohold building Bulgaria’s largest solar power plant

Eurohold building Bulgaria largest solar power plant

Photo: Oregon Department of Transportation / https://creativecommons.org/licenses/by/2.0/legalcode

Published

December 20, 2022

Country

Comments

comments icon

0

Share

Published:

December 20, 2022

Country:

Comments:

comments icon

0

Share

The Verila facility, under construction in hilly terrain south of Sofia, is set to increase solar power generation in Bulgaria by up to 12%. Works on the photovoltaic plant, developed by Eurohold, started in September.

The construction of Bulgaria’s largest solar power plant is due to be completed by spring 2023. The facility will generate green electricity with a peak capacity of 124 MW. The project for another segment, of 50 MW, is under development.

As of late November, there was an overall 1.03 GW in active photovoltaic facilities in the country, according to a statement from the contractor, Sunotec, which cited data from an unofficial renewables registry.

The biggest ones, at 50 MW each in connection capacity, are called Pobeda and Karadzhalovo, the list shows. The first one is located in Aytos near the Black Sea Coast. The latter, near Plovdiv, is operated by Austria-based Enery. Separately, SENS LSG has just finished a solar power plant of 66 MW in peak capacity in Dalgo Pole in the Plovdiv area.

It means the project that is underway is set to add up to 12% to Bulgaria’s installed solar power capacity. The investor, Eurohold, bought ČEZ’s assets in the country in 2019.

Eurohold Sunotec Bulgaria largest solar power plant

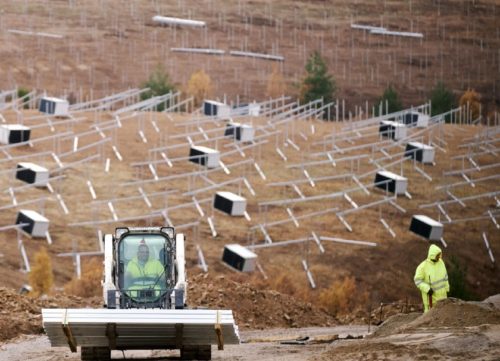

Photo: Sunotec

Steepness is biggest challenge

Sunotec is a domestic company, but with a second headquarters in Germany. It said its employees started the works on the ground-mounted PV facility in September.

The location is in the Verila mountain range near Dupnitsa (Dupnica), a town south of capital Sofia. Sunotec stressed that the nature of the terrain is the greatest challenge. The company is tasked with engineering, project management, procurement and construction of the facility with 220,230 modules.

Lower temperatures contribute to solar power output

“The location of the solar power plant at an altitude between 700 and 1,000 meters above sea level, with slopes as steep as 18 degrees, is one of the most adventurous and unique in Europe. The lower temperatures caused by the high altitude contribute to the generation of additional power. However, this also means that we have to adapt the machinery as well as the sequence of implementation to the challenging topography of the site,” said Sunotec’s Country Manager Valentin Gospodinov.

The project is one of seven that Sunotec is currently implementing in Bulgaria.

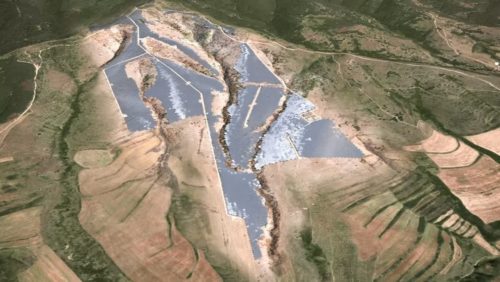

Sunotec Bulgaria largest solar power plant
Photo: Sunotec

Eurohold is installing two substations on its own

The Verila project, in the vicinity of the village of Kraynitsi, spans 130 hectares. The investment is worth more than EUR 100 million, according to earlier announcements.

Just last week, the Municipal Council of Dupnitsa agreed to sign a preliminary contract with Verila Solar Park 2 for a photovoltaic plant on a 236-hectare site on Kraynitsi territory. Eurohold said it would install 50 MW and that the project is scheduled to be completed in 2024. It added that it is building two electricity substations and that they would be donated to the country’s Electricity System Operator (ESO).

Council member Emil Gushterov, chief of the municipal parliament’s economic commission, stressed that the two substations are worth a combined EUR 11.7 million. He estimated that the investor’s donations to the municipality through infrastructure would be worth EUR 102,000.

According to the International Renewable Energy Agency, Bulgaria had 1.2 GW in solar power capacity at the end of last year.

Comments (0)

Be the first one to comment on this article.

Enter Your Comment
Please wait... Please fill in the required fields. There seems to be an error, please refresh the page and try again. Your comment has been sent.

Related Articles

ems ai transmission

EMS plans to use AI in construction approvals

21 November 2024 - EMS has decided to automate its construction approval procedure by introducing state-of-the-art AI solutions

IPTO ENCS cybersecurity grid

Greece’s IPTO joins European Network for Cyber Security

21 November 2024 - The European Network for Cyber Security (ENCS) has announced that IPTO has officially joined the network as a full member

montenegro gvozd epcg nordex agreement

Montenegro’s power utility EPCG begins construction of Gvozd wind farm

21 November 2024 - Wind farm Gvozd will be the first large-scale power generation facility to be built by EPCG in more than 40 years

Bulgarian waterworks firm installs in pipe hydropower generator

Bulgarian waterworks firm installs in-pipe hydropower generator

21 November 2024 - A waterworks and sewerage firm in Bulgaria produces electricity using an in-pipe hydropower device in a supply line
